The Diary of a Building – Treska T1
Strategically located in the heart of Skopje’s Centar municipality, the Treska Complex represents a new symbol of urban and modern living at one of the most sought-after locations in Macedonia.
Built according to the proven Golden Art system, using top-quality materials from renowned manufacturers, Treska guarantees durability, safety, and prestige for its future residents.
With secured parking spaces on multiple levels, the complex will offer practicality and comfort in everyday life.
When completed, Treska will represent a new city within the capital – a vibrant, dynamic and inspiring space for future generations.
📌 Here you can follow the full progress of construction and the transformation of this unique residential and commercial complex.
Materials: click here
Energy class: А
For information regarding available apartments, pricing, and additional details, please contact us at 071/225-888 or 075/225-888.

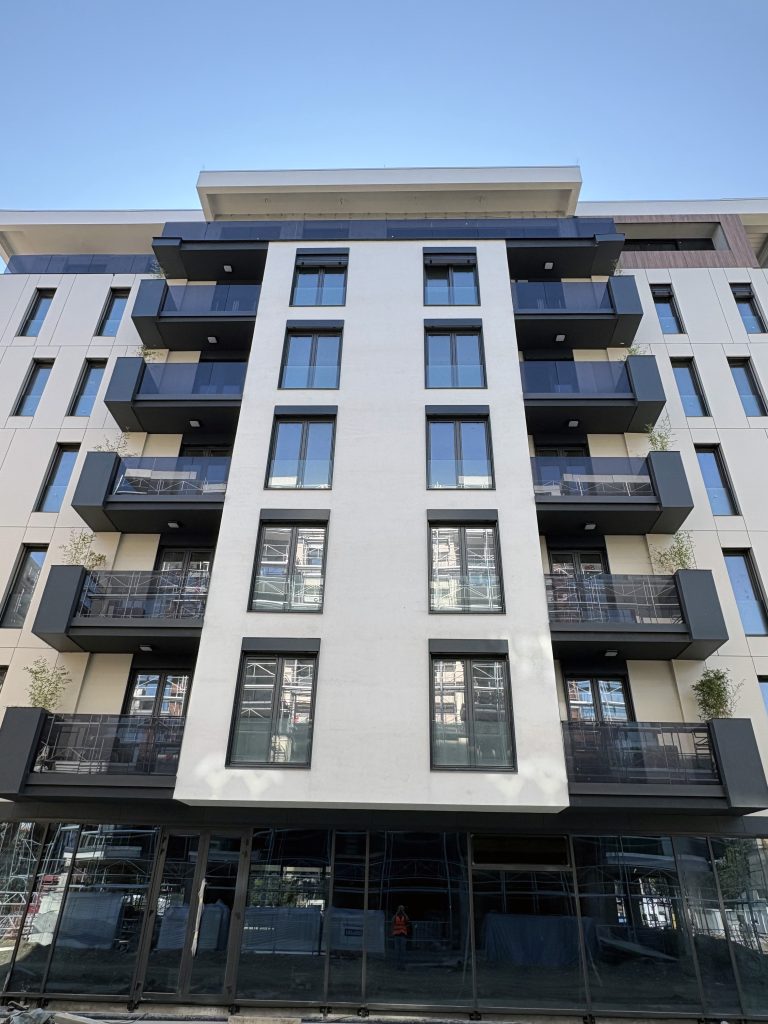

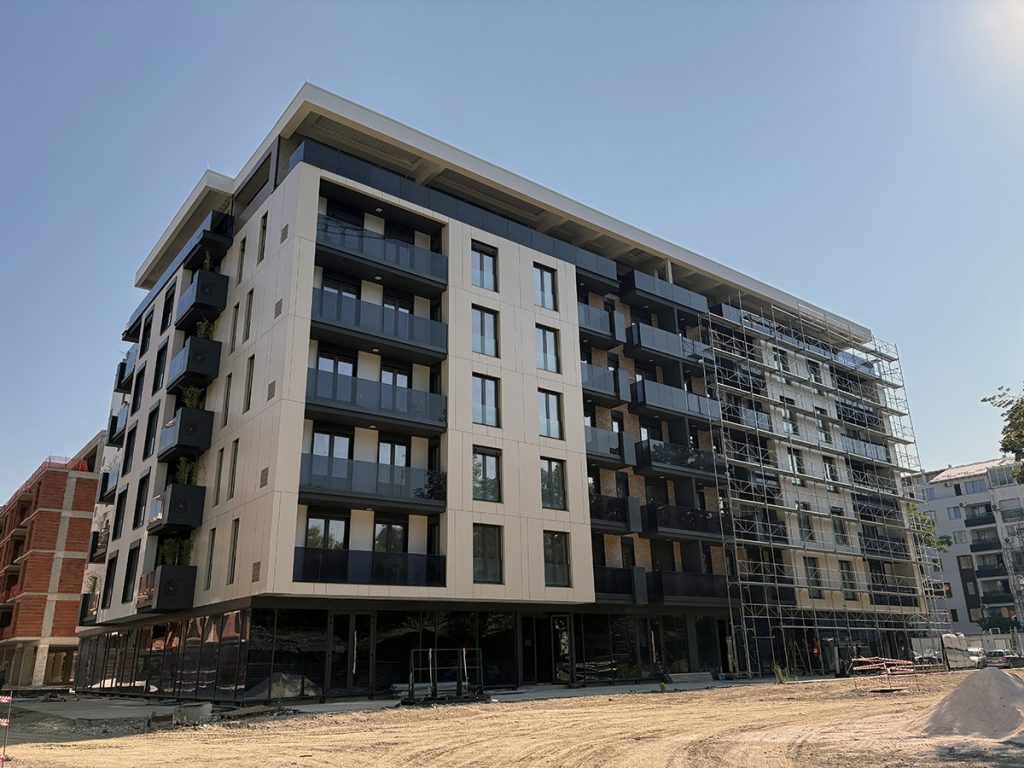

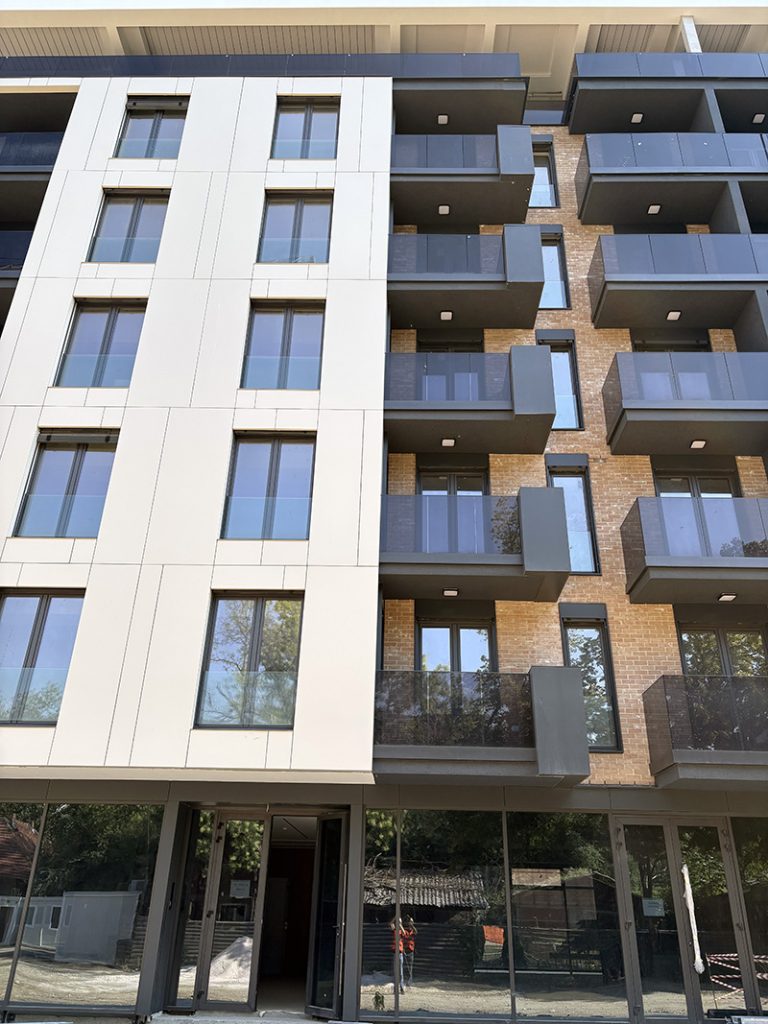

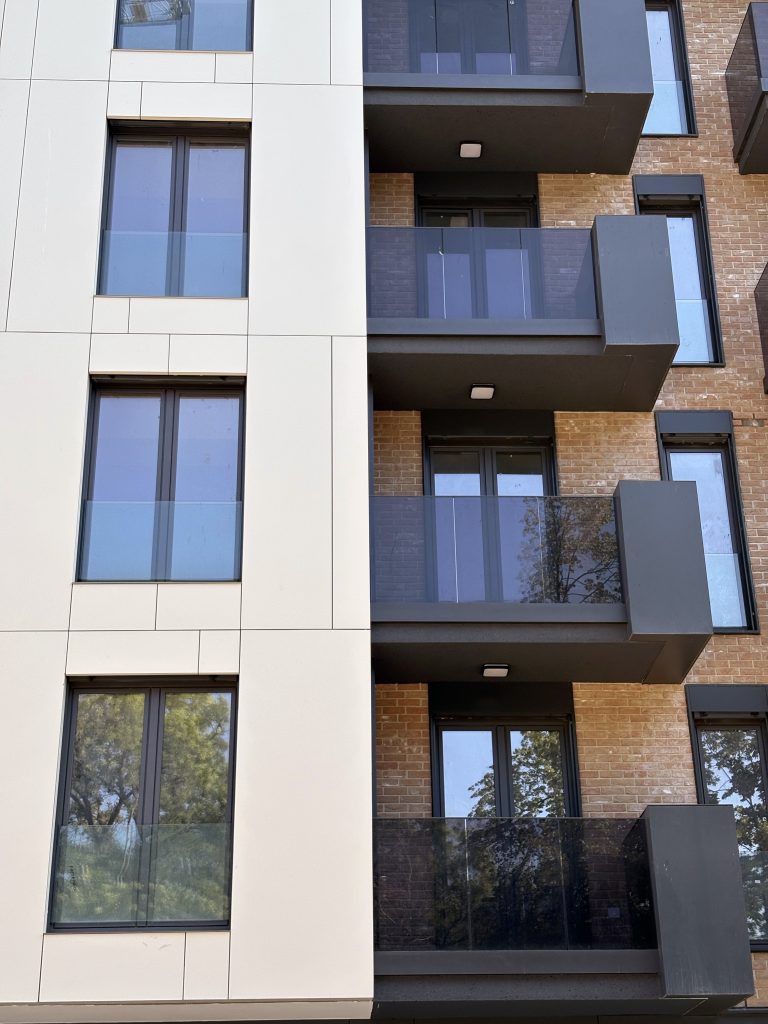

17.07.2026
Демонтажа на фасадно скеле на влез 1. Припрема за изработка на натстрешница за рампа за во гаража.
11.06.2026
The railing in the staircase core has been installed, and the entrance area has been fully completed.
26.03.2026
The façade is in the final stage of completion. The installation of the fittings is being finalized, the staircase core has been fully painted, and the finishing works on the entrance area are also being completed.
16.03.2026
25.02.2026
The glass shopfronts for the commercial units have been installed, along with the entrance door screens. Works are currently ongoing in the staircase core, including the installation of trims and wall finishing. Fundermax façade cladding is being installed on the north and east sides.
02.02.2026
The installation of glass shopfronts for the commercial units has been completed.
23.01.2026
Parking lines have been marked on level -1. Granite has been installed on the staircases and corridors, tiles have been placed around the lifts, and the granite installation in the entrance area has been completed.
26.12.2025
27.11.2025
Granite installation is ongoing in the corridors in front of the apartments. The installation of Fundermax cladding on the eastern façade of Entrance 1 is in progress, and the installation of ventilation ducts on level -1 has been completed.
13.11.2025
14.10.2025
The installation of internal apartment doors has been completed. Final painting works have been completed up to the 4th floor, while glass balcony railings are being installed on the façade.
23.09.2025
Installation of internal apartment doors on the 3rd floor is ongoing. Final wall painting works are being carried out on the 2nd floor, and façade works are in progress.
11.09.2025
16.07.2025
14.06.2025
10.05.2025
07.04.2025
14.03.2025
21.02.2025
05.12.2024
15.10.2024
Installation of bathroom tiles is ongoing, along with the installation of water meters and electrical systems throughout the apartments.
06.09.2024
21.08.2024
Cement plaster application works are currently being carried out in the kitchens and bathrooms of the apartments.
11.07.2024
Multiple works are ongoing on site. On the 2nd floor, insulation structures with plasterboard are being installed, ceiling finishing works are being carried out, while electrical installations are being completed throughout the apartments on the 1st floor.
30.05.2024
Works on site are progressing actively according to the planned schedule. Cement plaster is being applied in kitchens and bathrooms on the 1st and 2nd floors, preparations are underway for window installation on the 3rd floor, and electrical cabling is also being installed throughout the apartments on the same floor.
22.05.2024
Windows are being installed on the 2nd floor, while electrical cabling works are ongoing throughout the apartments on the 1st floor.
15.05.2024
Window installation has commenced on site, along with electrical cabling works throughout the apartments on the 1st floor.
10.04.2025
29.03.2024
25.03.2024
07.03.2024
29.02.2024
Completion of masonry works on the 4th floor, preparation for masonry works on the 5th floor, and preparation for electrical installations throughout the apartments.
19.02.2024
Construction of façade and partition walls on the 4th floor.
15.02.2024
Construction of façade and partition walls on the 4th floor. The roof structure is in the final stage of completion.
08.02.2024
29.01.2024
Construction of façade and partition walls on the 3rd and 4th floors.
22.01.2024
Roof structure works are ongoing. Construction of façade and partition walls is being carried out on the 1st and 2nd floors, while materials are being cleared from the remaining floors.
26.12.2023
Construction of the wooden roof structure. Façade wall construction is ongoing on the 1st and 2nd floors, while materials are being cleared from the remaining floors.
12.12.2023
Multiple activities are currently ongoing on site. Formwork for the roof slab is in progress, construction of façade walls on the 1st floor has commenced, and waterproofing works on the external walls are being carried out.
24.11.2023
Formwork installation for the slab.
10.11.2023
19.10.2023
Reinforcement and formwork works for the 1st-floor slab are ongoing. External wall insulation works are also being carried out.
29.09.2023
20.09.2023
Blessing of the foundations.
